Risk based testing (RBT) is a type of software testing that focuses on identifying and prioritizing high-risk areas of the software applications being tested. In simple terms, risk based testing is an approach that evaluates the features of software applications at high risk of failure based on software complexity.
Even though there are other software testing types like white box testing, grey box testing, and system testing that focus on testing every feature of software applications, why do we need risk based testing?
In the software development process, testing is indispensable for assuring the quality of software applications and evolves with time by introducing new software testing techniques and methodologies. Its primary focus is thoroughly testing every component, feature, line of code, and others.
However, an organization may face time and budget constraints that force the development team to make the most of it in the limited resource. In this case, the focus is given more to the features or components of software applications that matter the most. Here comes risk based testing, which allows testers to focus their time and resources on the testing software's most critical areas and improve the product's overall quality.
Overview
Why Not Just Test Everything Equally?
Because time and budget are finite, and treating every feature as equally important spends the most effort where it matters least. Risk-based testing ranks features by risk and concentrates on where a failure would hurt most, making the trade-off deliberate instead of accidental.
How Do You Decide What to Test First?
Score each area on two axes and multiply them: likelihood (how prone to failure) and impact (how bad the failure would be). The four pillars are risk identification, risk analysis, risk response planning, and continuous risk monitoring.
How Does It Differ From Requirements-Based and Session-Based Testing?
How Do You Know Which Areas Are Actually Risky?
Past defects are the strongest signal, so a risk model is only as good as the failure history behind it. TestMu AI's test intelligence surfaces flaky tests and failure trends from real runs, turning a risk register from a one-time guess into something you re-score with evidence each cycle.
Risk-based testing is a testing approach that prioritizes the features and functions to be tested based on the risk of failure. It's a strategy that focuses on the areas of the software that carry the highest risk, helping teams to use their testing resources more efficiently.
Risk based testing is an essential approach to software testing, helps reduce testing efforts and costs, identify critical defects early in the Software Development Life Cycle, and ensures the delivery of high-quality software applications to end users. Using Risk based testing, software professionals can make informed decisions about the testing process, focusing their efforts on areas that pose the highest risk to the software applications.
The factors that pose a high risk to software applications may include complex code, code critical to the function of the software application, etc. However, risk levels are also impacted by the type of features or software applications being developed. In risk based testing, such factors are addressed and help focus on the part of the software application that is more likely to encounter bugs.
Risk based testing serves a multifaceted purpose. Primarily, it establishes a framework to develop transparent communication among stakeholders concerning the software project risks. This framework helps define standard communication within the team, making risks visible and more amenable to being fixed.
The need for risk based testing arises because it is not always possible to exhaustively test every aspect of software applications within the available time and budget. By identifying and assessing the risks associated with the software applications under test, a risk based testing approach can help testers focus their testing efforts on the areas of the software applications that are most critical and likely to cause issues.
This can help ensure that the software applications are thoroughly tested within the available time and budget and that the most critical issues are addressed before the software applications are released to users.
Risk based testing can also help identify and mitigate risks early in the development process, which can help reduce the cost and impact of defects discovered later in the development cycle or after the software application is released.
Note: Get instant access to 3000+ desktop and mobile environments.Try TestMu AI Now!
Suppose a software testing team works on an eCommerce website that allows customers to purchase products online. Your team has identified the following risks:
Based on these risks, your team would prioritize testing efforts accordingly. For example, you may allocate more resources to testing the payment gateway to ensure it is secure and prevent potential breaches. Additionally, you would prioritize testing the search functionality and checkout process to ensure they are user-friendly and accurate to avoid losing customers.
By adopting a risk based testing approach, your team can focus its resources on areas of highest risk to ensure that critical issues are addressed first. This approach can help you identify and mitigate potential problems before they become major issues and ultimately deliver a higher-quality product to your customers.
Risk based testing is an essential part of software testing and offers several benefits in ensuring the quality of the software applications. It is important to know its benefit to broaden the knowledge of risk based approach in testing and understand its wide use in software testing. Here are some of its key benefits:
Risk based testing is essential to develop high-quality software applications and ensure no risk is involved that could impact its functionality. To get started with this, you must understand the key feature of risk based testing. Here are some of those:
To perform risk based testing correctly, it is essential to know the scenario where it can be implemented. With this, you can execute it at an accurate time. Here are some situations when it should be performed.
Risk in testing is the occurrence of unexpected events that impact the software application's success and quality. Such events might have happened in the past or may be an issue for future occurrences. This may affect the cost, technicality, and quality of the standard of the software application.
The risk may include errors, issues, vulnerabilities, and defects that negatively impact the software application's functionality. The main purpose of risk assessment is to find and evaluate such risks and determine their level for prioritization of testing efforts.
However, risk assessment is challenging; how can you prioritize or determine the level of risk? To answer this, you have to look at three crucial aspects of software applications to determine the risk level:
Understanding the type of risks that directly can impact the quality of software applications and identifying potential problems is crucial. Type of risks can be broadly classified into two types:
The negative risks pose a threat to the success of software projects. With risk based testing, you gain insight into these risks for mitigating them and ensuring the quality of the software application.
Following are the groups of negative risks encountered by the team during the software development process.
The testers must identify and mitigate the negative risk that could impact software applications' success.
Testers play a crucial role in assessing the risks associated with the software application. They must conduct a comprehensive risk assessment outlining the proposed solution's testing approach. If the testing strategy is insufficient, the likelihood of critical software failures when the software is deployed in production will escalate.
Having a thorough understanding of the software application's risks allows testers to evaluate whether the software is ready to go live based on the business' perceived risks.
Risk based testing entails planning, designing, and executing testing operations based on the priority of the modules. The focus areas for assessing software application's risk should include the following areas:
By prioritizing the testing of these areas, testers can reduce the likelihood of software application failures in production and improve its quality.
Risk based testing is broadly classified into two main testing techniques, which are light-weight and heavy-weight risk testing techniques. These techniques are subjective and require the skills and experience of the development and tester team.
This technique is related to risk analysis which is mainly formal and focuses on technical and business risks by considering their probability and the factor impacting them. Light weight risk based testing is considered lightweight because it does not involve a detailed analysis of all possible risks. It mainly addresses risk criticality, complexity, and other factors in software applications.
One of the main attributes of lightweight risk based testing techniques is that they focus on only two risk factors:
Lightweight techniques depend on simple qualitative judgments and scales instead of using complex mathematical models to calculate risk. For example, a team might rate the likelihood of risk as high, medium, or low and the impact as severe, moderate, or minor. These ratings can then be used to prioritize testing efforts.
There are three types of lightweight risk based testing techniques:
Heavy-weighted risk based testing is an approach for testing software that concentrates on prioritizing testing activities according to the level of risk associated with various areas of the software application.
In this method, the testing team identifies the most critical areas of the software application with the highest potential for failure and focuses their testing efforts on those areas. This aids in ensuring that the most critical components of the software undergo thorough testing and that any potential issues are identified and addressed before release to users.
Heavy-weighted risk-based testing requires examining the software requirements, design, and architecture to detect potential risks and prioritize testing activities accordingly. The testing team may also refer to historical data and industry best practices to inform their risk assessment.
There are four main types of heavy-weight risk-based testing techniques:
It involves analyzing each component or step in the process to identify potential failure modes, their effects, and the likelihood of occurrence. FMEA helps identify high-risk areas and prioritize actions to prevent or mitigate potential failures.
The steps of FMEA involve the following:
It considers both observed failures raised from testing or production and potential failure rise from quality risks. Such failures are then subjected to root cause analysis which starts from defects causing failure, then with errors causing the defect, and continuing on identifying the root cause.

The software testing technique in risk based approach depends upon the product, process, and project considerations. Quality risk analysis is integrated early in every sprint for Agile undertakings, and risks are cataloged alongside user story tracking. A precise estimate of test effort is crucial to successful project culmination.
For a complex system of systems, risk analysis is required for each individual system and the system of systems in its entirety. Projects that are mission-critical or safety-critical necessitate higher levels of formality and documentation in their risk based testing techniques. This method can be utilized at any phase, including user acceptance testing.
The essential component for effective risk based testing is the involvement of the appropriate team of stakeholders in risk identification and evaluation. These stakeholders usually fall into two groups: business and technical stakeholders. Every stakeholder brings their distinct perspective on what constitutes quality for the product and their priorities and concerns regarding quality.
Risk based testing involves a series of steps that must be followed to test a software application successfully. Below are the steps explained in detail:
The first step in risk based testing involves identifying the potential risk associated with software applications. You can identify the risk by various means. Some of those are
It is crucial to have clear communication amongst the development team who have encountered any potential risk in the past. This will help to understand the vulnerable area in the software application development, which could impact its functionality and performance. Along with this, the team also analyzes the requirements, design specifications, and documentation to identify potential risks.
At this phase, a risk spreadsheet is maintained where identified risk is further divided into sub-risks called risk breakdown. Risk breakdown structure is a hierarchical representation of the list of identified risks organized by categories and sub-categories. This helps easy identification, analysis, and communication of software project risk to the stakeholders.
Registering the risk in a spreadsheet allows for tracking and monitoring risks throughout the software development process. You can identify the risk-prone area that eases resource and time allocation for risk management.

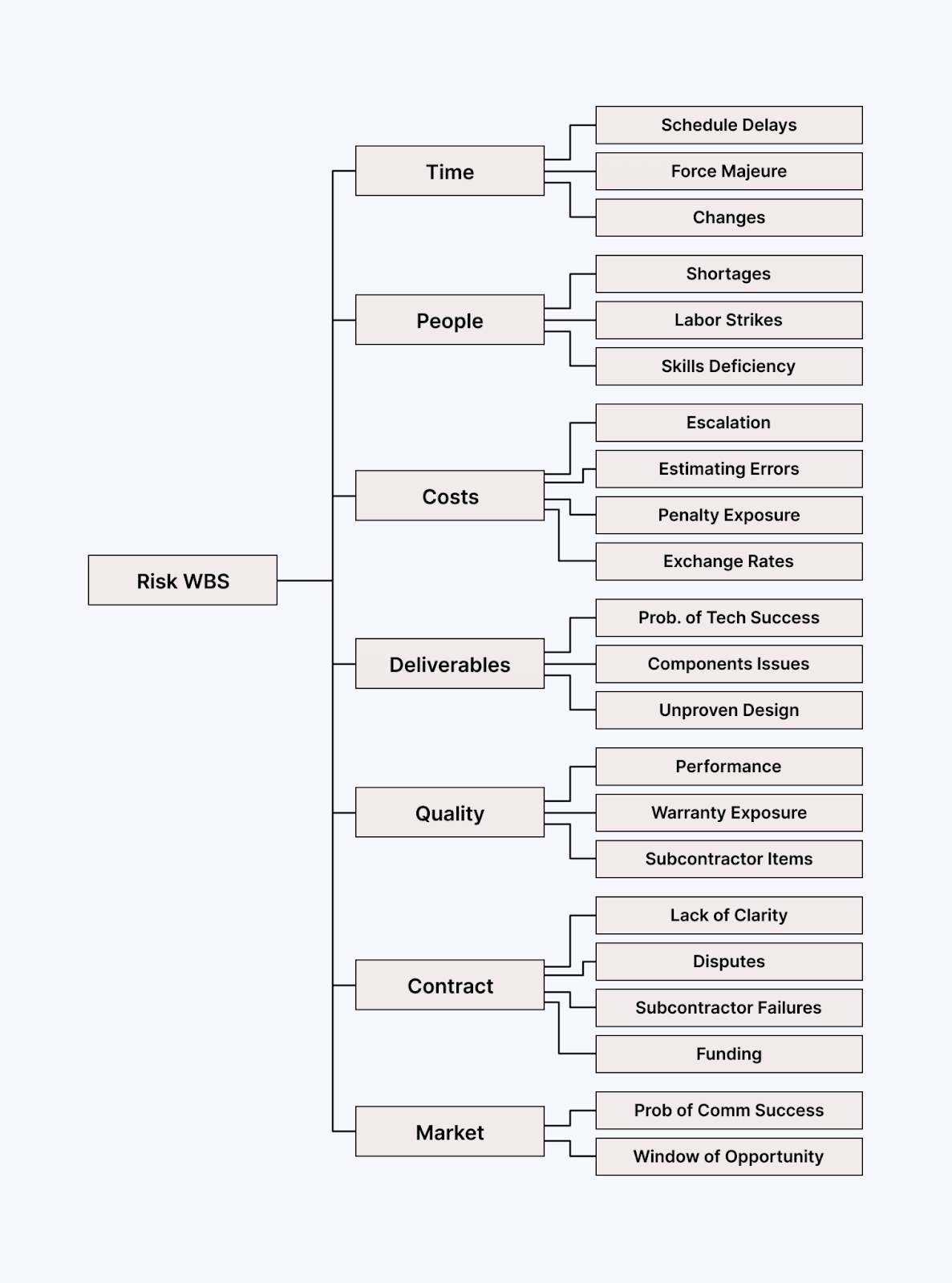

Here is an example of a risk breakdown structure, as shown in the below illustration. Typically it categorizes risk as external (associated with the market, legal and regulatory factor) and internal (associated with project management, technology, and resources). However, other than this, the risk associated with environmental and safety factors are also considered. Further, those risks are also subdivided into specific risks, which are then critically assessed.

When the risk is identified and sorted, risk assessment begins. However, risk assessment can also go parallel with risk registration to identify the likelihood and impact associated with each risk. In some cases, risk assessment also occurs during identification using a checklist.
Here the risk is again categorized into appropriate types like performance, reliability, etc. Some organizations use ISO 25000 quality characteristics for categorizing. However, many others use different categorizing schemes.

After potential risk is listed and categorized based on assessment, they are analyzed and filtered using quantitative and qualitative risk analysis methods. However, it is important to know about the factor impacting the likelihood of risk and the factors influencing the impact of risk. Here are those:
Factors impacting the likelihood of risk:
Factors leading to the impact of risk:
The main objective of risk analysis is to differentiate between high-value and low values test cases to assign priority value. This involves the following steps:

Step 1: Using 3X3 Grid
In this method, the development team assesses each functionality and non-functionality of the software applications and associated test cases for likelihood or failure and the impact of failure.
The likelihood of failure of each functionality is analyzed by technical experts and categorized as likely, quite likely, and unlikely to fail.

The impact of the failure of such functionality is categorized as minor, visible, and interruption.

Step 2: Likelihood and Impact of Failure
The likelihood and impact of each identified risk are assessed and rated as either low, medium, or high likelihood, and minor, moderate, or severe impact. The resulting values position the corresponding test cases on a 3X3 grid.
To quantify the likelihood and impact, multiply the two values to calculate the risk priority number. However, in most cases, the risk level is also analyzed qualitatively, and the technique involved is Risk Matrix. This is used to find the probability and effect of risk.
Prioritization and Risk Assessment Matrix:
The risk rating measures the potential impact of risk and is calculated by multiplying the probability of the risk occurring by the severity of its consequences. This formula is commonly expressed as
Risk Rating = Probability x Severity
The prioritization and Risk Assessment Matrix is leveraged to evaluate the probability and severity of each recognized risk, also called the probability impact matrix; this matrix provides a quick overview of the risks and their corresponding priorities.
The likelihood and severity of the ambiguous circumstance are multiplied to gauge the risk rating. Probability is a percentage and can be classified as follows based on the possibility of the event happening:

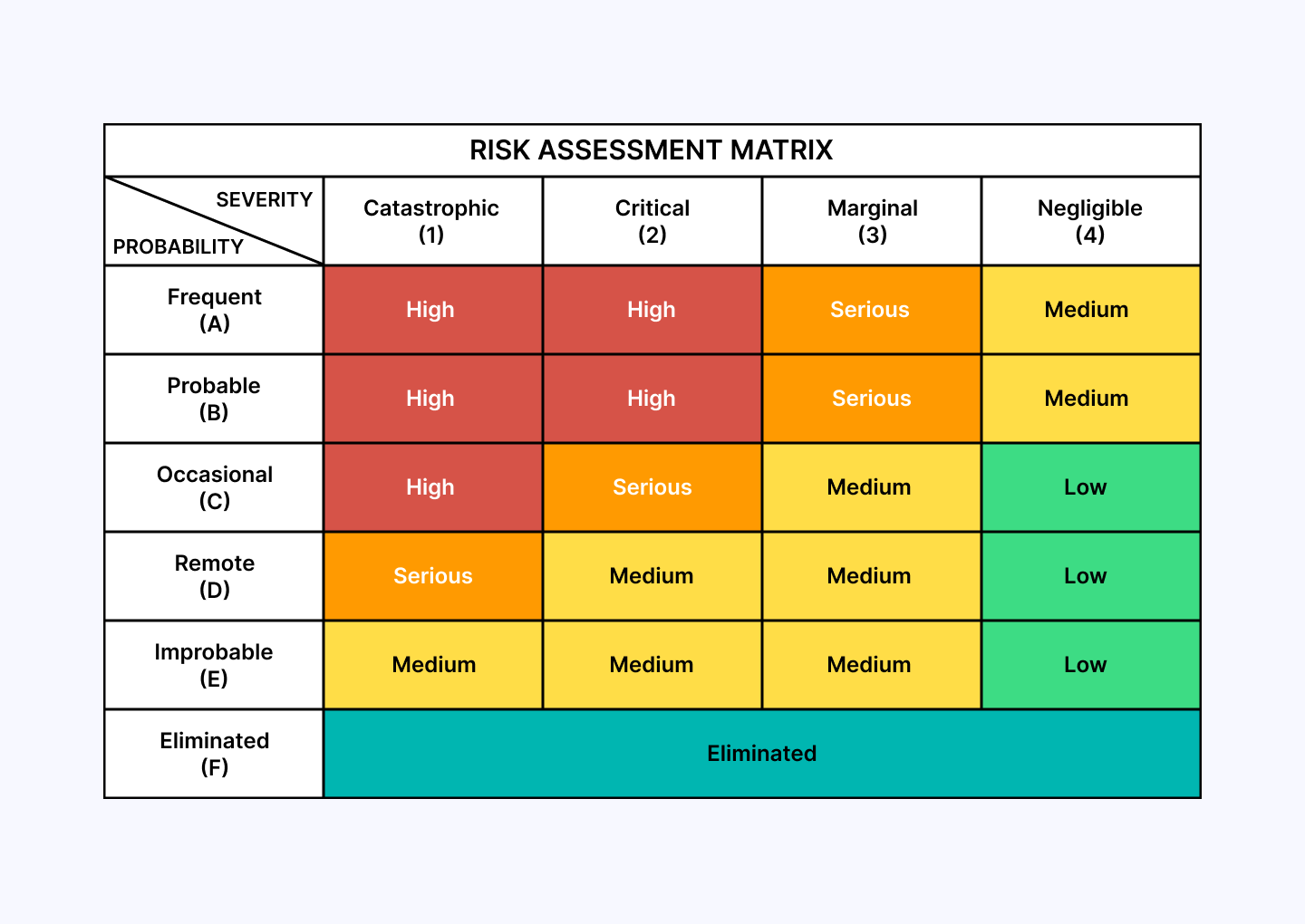

Severity is evaluated on a scale of 1 to 4 and can be classified as Catastrophic, Critical, Marginal, or Negligible based on the event's impact.
Afterward, the resulting risk rating is applied to assign the risk to one of the four priority categories: Serious, High, Medium, or Low. These priority categories are charted against the severity and probability of the risk, as shown in the below matrix.

By utilizing the Prioritization and Risk Assessment Matrix, software development teams can promptly detect and prioritize risks, permitting them to concentrate their testing efforts on the most crucial areas of the software. This ensures that possible issues are resolved early in the development process, diminishing the probability of defects or failures and elevating the software's overall quality.
After assessing the risk level of each test case, the Risk Assessment Matrix, utilizing the probability and impact of failure, positions them on a 3x3 grid to determine their priority. This method enables the identification of high and low-value tests.
Step 3: Testing Priority Grid

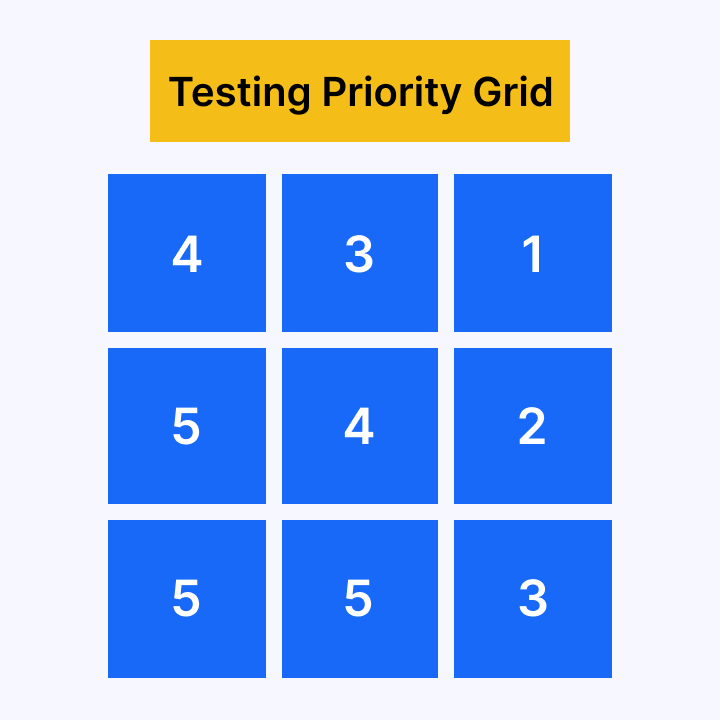

This methodology involves the creation of a Testing Priority Grid based on the positioning of the test cases in the 3X3 grid outlined in Step #2.
The tests are prioritized and labeled with priority numbers 1, 2, 3, 4, and 5 based on the risk ratings assigned in Step #2. Tests with the highest risk ratings are assigned priority 1 and are situated in the top right corner of the grid, while the lower priority tests are given higher numbers.

After priority numbers sort the test cases, they are executed according to the order of priority. Tests with the highest priority are executed first, as they pose the greatest risk to the project. In contrast, lower-priority tests may be executed later or even removed if necessary.
Using the Testing Priority Grid, the testing team can prioritize their testing efforts based on the potential impact of each identified risk, ensuring that the most important tests are conducted first, and potential risks are addressed early in the development process. This approach is designed to improve the overall quality of the software and reduce the likelihood of defects or failures.

Step 4: Details of Testing
In the fourth stage of the testing process, the emphasis is on determining the appropriate degree of detail for testing based on the prioritization of the test cases. Tests assigned a higher priority ranking, denoted by a value of 1, are deemed “More Thoroughly” and thus require a more comprehensive level of testing. To ensure that these high-priority features and their associated test cases are tested to a high standard, proficient testers must be assigned to the task.

The same approach is taken for test cases with priority rankings of 2, 3, and 4; however, the level of detail involved in testing these cases may be reduced compared to those with a higher priority ranking. Finally, for test cases with a priority ranking of 5, a decision may be made to de-scope these features and tests based on the time and resources available. This implies that these test cases may need to be tested or receive minimal testing.
Risk Response Planning
It involves thoroughly analyzing the identified risks to determine if a response is necessary. The risk owner will assess whether it requires action during the project planning or monitoring phase or can be left unattended.
If the risk demands a response, the risk owner will evaluate various options to minimize the probability and impact of the risk on the project. These options include adjusting the project plan to eliminate the risk, allocating additional resources to mitigate the risk, or modifying the testing strategy to concentrate on the areas of the project most affected by the risk.
The primary objective of risk response planning is to minimize the impact of risks on the project and ensure that the project is completed successfully within the desired time and budget constraints.
Risk Mitigation
Risk mitigation involves taking measures to decrease the risk's possibility and/or impact. It can be done by eliminating or lowering the risk to an acceptable level. Risk mitigation aims to reduce the likelihood of any potential harm caused by these risks in the software applications and ensure that the establishment is adequately equipped to tackle any unforeseen circumstances.
There are many ways to mitigate risks. For example, an organization could implement safety protocols, establish redundant systems, train employees to handle emergency situations, or invest in insurance coverage. By taking these measures, the establishment can minimize the impact of potential risks and deter them from metamorphosing into significant predicaments.
Risk Contingency
Risk contingency concerns the probability of an unanticipated event with an indeterminate or unforeseeable impact. A contingency plan, or an action plan or backup plan, is a calculated measure to brace for worst-case scenarios. The purpose of a contingency plan is to ascertain what measures can be taken for an unpredictable event, such as a natural calamity, cyber assault, or supply chain disruption.
Risk Monitoring and Control
Risk monitoring and control processes are utilized to track the identified risk, monitor the residual risks, detect new risks, evaluate the change, execute the response plan, and monitor risk triggers. The primary purpose of this step is to effectively manage the risk throughout the software project and business process.
You can use several techniques and tools in risk monitoring and control, like risk assessments, risk audits, variance, and trend analysis, retroactive meetings, etc. when you implement these techniques; you will be able to manage the risks and ensure that the preparedness to respond to potential issues on time.
The risk based approach is a comprehensive strategy that involves scrutinizing the requirements of a project and assessing risks based on the probability and potential impact of each requirement. By identifying high-risk areas and prioritizing needs, the approach helps ensure that the highest-risk items are tested first. This is done by using a risk register to list identified risks and performing risk profiling to understand the risk capacity and tolerance levels.
The approach involves planning and designing tests according to the risk rating. The highest-risk items are given the most intensive coverage by employing appropriate testing approaches and design techniques. To ensure maximum coverage, the testing approach encompasses multiple functionalities and end-to-end business scenarios.
Furthermore, the approach employs peer review and dry runs to identify defects and mitigate risks. The results are reported and analyzed, and contingency plans are created for high-exposure risks. The approach also involves defect analysis and prevention, retesting, and regression testing to validate fixes based on pre-calculated risk analysis. High-risk areas receive the most intensive coverage.
Periodic risk monitoring and control, residual risk calculation, and reassessment of risk profiles are also critical components of the approach. Contingency plans are implemented as necessary. The approach can be used at every level of testing, and exit criteria or completion criteria are established based on risk levels. The ultimate goal is to ensure that all key risks are addressed with appropriate actions or contingency plans and that risk exposure is at or below the acceptable level for the project.
Risk based approach is used during system testing to prioritize and address testing efforts on the system's critical components based on potential associated risks. Such an approach is helpful to detect any risk in the system and determine the likelihood of its occurrence and impact on the system and users. It involves three different tests, which are explained below:
The true capability of testing in real-world scenarios can only be leveraged when tested on real browsers, devices, and operating system combinations. Cloud-based digital experience testing platforms like TestMu AI offer real device cloud to perform manual and automated testing of your web and mobile apps on over 3000+ real browsers, devices, and operating systems.
TestMu AI can help in your risk-based approach to testing by providing a scalable online browser farm to test software applications (websites or mobile apps) across a wide range of combinations. Furthermore, you can create automated test suites or scripts that cover high-risk scenarios using automation testing frameworks like Selenium, Cypress, Playwright, and more.
Check our documentation to get started with automation testing.
Risk based testing is an exhaustive process that focuses on critical functionality and related potential risk associated. In this process, it is important to evaluate that the software application is thoroughly tested and that there is no miss of any potential risks. For this, a checklist help ensures that all critical components of software testing are tested. Here are some points to consider:
Risk-based testing is a prioritization discipline before it is a tooling problem, so the useful question is not which tool is most popular but which capabilities the approach actually depends on. Judge any candidate against these four, ideally alongside your automation testing tools:
TestMu AI's Test Manager covers those four in one workspace: a single traceability matrix connects requirements to test cases, execution history, and defects, so coverage gaps surface before a release rather than after, and manual outcomes land in the same cycle view as automated pipeline results. For a wider survey of the category, see our guide to test management tools.
Catch up on the latest testing tutorials around Selenium automation, Cypress testing, and more. Subscribe to the TestMu AI YouTube Channel for quick updates.
Knowing different phases and approaches to risk based testing, it is equally important to be aware of the steps involved in executing it successfully. These are the steps you can follow to run Risk Based Testing.
The main goal of risk based testing is to identify and mitigate the high-risk area of the software application. In this process, it is important to evaluate the effectiveness of the testing process so that we can know how successfully identified risks in the software application development process are mitigated. Here are some known risk based testing metrics:
The test report preparation is the process of creating documents that can be communicated to the project stakeholder on the risk based test result. Preparing a test report to clearly understand the testing process and compare the pre-defined test objective with the test result is essential. Risk based test reports need to be detailed, organized, and concise.
The following are the steps to prepare a test report:
It also involves information on the number of test cases planned vs. executed, number of test cases passed/failed, number of defects identified and their status & severity, number of defects and their status, number of critical defects- still open, environment downtimes - if any, showstoppers - if any, test coverage report.
Strip risk-based testing back and four activities carry it. Teams that struggle with the approach have usually dropped one of them, and it is almost always the fourth.
One technique worth knowing for the first two pillars is FMEA (Failure Mode and Effects Analysis), which walks each component, asks how it could fail, and scores the consequence. It is heavier than most teams need for a web app, but it is a useful discipline when the cost of a miss is measured in more than churn.
Requirements-Based Testing (RBT) derives every test case directly from the Software Requirements Specification (SRS). Where risk-based testing asks "what would hurt most if it broke", requirements-based testing asks a stricter question: "is every stated requirement proven?"
The instrument that makes it work is the Requirements Traceability Matrix (RTM), a table mapping each requirement to the test cases that exercise it. Read down the matrix and an untested requirement is visibly a hole rather than an oversight nobody noticed. That is the point: RBT targets 100% requirement coverage, which is a different goal from 100% code coverage and a much different goal from risk-based prioritization.
This matters most where coverage is not a preference but a condition of shipping. Safety-critical industries mandate it: DO-178C governs airborne software certification, and ISO 26262, titled "Road vehicles - Functional safety", governs automotive electronics. In those contexts a requirement without a traced test is not a backlog item, it is a blocked certification.
The honest trade-off: RBT proves the specification and nothing else. If a requirement is missing or wrong, a perfectly green RTM says everything passed. That blind spot is exactly what risk-based and exploratory approaches exist to cover, which is why mature teams run more than one.
Session-Based Testing (SBT) is exploratory testing with an accountability structure bolted on. It answers the standard objection to exploratory work, which is that it produces insight but no evidence, by making the session itself the unit of measurement.
Session-Based Test Management (SBTM) has six elements, and skipping any one of them collapses it back into unstructured clicking:
SBT pairs naturally with a risk-based approach: use risk analysis to decide which areas deserve charters, then spend sessions there. The risk register picks the target, and the session structure proves you actually went.
| Parameter | Risk-Based | Requirements-Based | Session-Based |
|---|---|---|---|
| Driving question | What hurts most if it breaks? | Is every requirement proven? | What do we not know yet? |
| Test source | Risk register, likelihood and impact scores | The SRS, traced through an RTM | A charter, plus the tester's judgment in the moment |
| Documentation | Risk register and prioritized cases | Heaviest: full traceability matrix | Lightest: session reports and debriefs |
| Coverage goal | Deliberately partial, ranked by risk | Complete against the spec | Unbounded by design |
| Best fit | Short windows, limited resources, uneven risk | Regulated and safety-critical work | New or poorly specified features |
| Main blind spot | Mis-scored risk goes untested | A wrong or missing requirement still passes | Depends heavily on tester skill |
There are different ways to analyze and evaluate risk in software applications which undergo various forms based on context. Despite this, there are common mistakes that should be avoided in risk based testing. Some of those are as follows:
It is recommended to start the risk analysis during the planning and development phase of the Software Development Life Cycle to evaluate and develop an effective test approach correctly.
Note: Expedite release velocity with blazing-fast test automation. Try TestMu AI Now!
Risk based testing is an approach to maximize the efficiency of the testing and comes with its own set of challenges. Such challenges need to be understood so that they can be addressed while performing risk based testing. This will help you ensure no miss of the critical risk area of the software application. Here are some of the common challenges:
Risk based testing is an important aspect of software development, and there exist several best practices to ensure its success:
Risk based testing is an approach to software testing that prioritizes the critical functionality of the software or system. This strategy aims to optimize the testing process's efficiency and effectiveness, eventually improving user experience and high-quality software.
In this approach, the level of risk is identified, assessed, analyzed, and mitigated based on its prioritization. This strategy reduces over-testing, thereby optimizing the efficiency of the testing process.
The risk based approach requires effective collaboration and communication between the stakeholders like developers and testers involved in the software project. When you involve all views in the risk assessment, the team can easily ensure potential risk identification and its fixes.
